Relocating a concrete batching plant is an operational, compliance, and capital decision. When sequenced correctly, it extends the working life of existing equipment and avoids the cost of a new purchase. When handled poorly, it results in weeks of unplanned downtime, permit failures, and recommissioning costs that can rival replacement.
Relocation success depends less on dismantling skill and more on how well permits, site prep, utility tie-ins, transport logistics, rigging, calibration, and production restart are planned before the first bolt is loosened.

Relocation success depends on careful coordination of permits, logistics, utilities, and site preparation.
When is relocating worth it?
Relocation only makes financial sense when the total cost - downtime, labor, transport, crane work, civil works, permitting, recommissioning, and lost production - comes in well below replacement. Plant type, age, condition, and the expected operating life of the new site all affect that calculation significantly.
Stationary plants: difficult and expensive to relocate
Stationary concrete batching plants are not designed for relocation. They are assembled piece by piece on location, with custom foundations, pits, and trenches. Cement silos are anchored to deep footings. Aggregate bins are integrated into the civil structure. Screw conveyors, weigh hoppers, and batching controls are wired and calibrated in place.
Relocating a stationary plant means reversing all of that engineering, transporting dozens of individual components as oversize loads, and rebuilding site-specific infrastructure from scratch. The result is high cost, high risk, and a long production gap.
The general rule: stationary plants should only be relocated if they are modern, well-maintained, and the new site will operate for many years. If the plant is aging or the new site is temporary, replacement is almost always the smarter investment.
Mobile plants on wheels: moderately difficult to relocate
Mobile concrete batching plants on wheeled frames consist of frameworks carrying dosing and conveying equipment, scales, and a mixer. Larger setups typically consist of two units: a mixing unit and a separate aggregate bin unit.
Moving the full production system means coordinating multiple trucks, oversize load transport approvals, and sequential reconnection at the new site. Key constraints to plan for:
- Thermal insulation for cold-weather operation must be dismantled and reinstalled separately
- Axles that have not been used for extended periods can present mechanical problems during transport
- Additional storage units, cement silos, and control units each require separate transport arrangements
Containerized plants: easy and economical to relocate
Tecwill's containerized Cobra and Arcamix plants are the most relocation-friendly design available. They are built in modules sized to standard sea container dimensions, with aggregate bins, mixer units, screw conveyors, weigh hoppers, cement silos, and batching controls preinstalled and factory-tested. Thermal insulation is built in and does not need to be removed for transport. Foundations and loading ramp elements are designed to be mobile.
Relocation becomes primarily a logistics exercise: disconnect utility tie-ins, lift container modules using a standard lifting plan, load onto transport, move to the new site, set down, and reconnect via plug-in connectors. A well-prepared containerized plant can often be dismantled, transported, and mechanically reassembled within 1-2 days.
Pre-move assessment
Before committing to a relocation, confirm:
- Remaining structural life of the plant
- Condition of mixer units, screw conveyors, aggregate bins, cement silos, weigh hoppers, and batching controls
- Site limitations at the new location that would require new foundations, pits, or trenches
- Utility requirements: power, water, and aggregate heating
- Dust suppression and particulate emissions controls required at the new site
- Estimated downtime and its cost in lost production revenue
Schedule the move during a low-production period. The revenue loss from a poorly timed relocation can exceed the entire cost of the physical move.

A pre-move assessment helps identify site requirements, equipment condition, and potential relocation risks before work begins.
Build the relocation plan before touching the plant
A successful move starts with a documented relocation plan, not a dismantling crew. Many relocations begin with equipment being disconnected before the new site is ready, transport routes are approved, or utility tie-ins are confirmed. That sequence guarantees delays.
The plan should cover:
Pre-move documentation
- Tagged equipment inventory: mixer units, aggregate bins, cement silos, screw conveyors, weigh hoppers, batching controls, and ancillary equipment
- Layout drawings of the current installation and the proposed new site layout
- Operation and maintenance manuals, maintenance records, spare part inventories, and PLC program backups
- Equipment condition review to identify what will be reused, upgraded, or retired
Transport and rigging
- Rigging and lifting plan for each major component or module
- Oversize load transport approvals for all road sections on the planned route
- Sequence for emptying aggregate bins, cement silos, weigh hoppers, and screw conveyors before dismantling
- Crane capacity requirements and lift point specifications
New site preparation
- Foundation requirements: standard concrete pads, foundation-free base frames, or full civil works
- Utility tie-ins for power supply, water, compressed air, and aggregate heating
- Dust suppression and drainage infrastructure
Commissioning and restart
- Electrical and automation reconnection for batching controls
- Calibration of weigh hoppers and dosing systems
- Moisture correction verification for aggregate moisture measuring equipment
- Test batching to confirm mix consistency before full production resumes
Permits before dismantling starts
Confirm these before any equipment is disconnected:
- New site permit status and any required pre-move notifications
- Air quality and dust suppression requirements at the new location
- Local building and utility connection permits
- Transport route approvals for oversize loads
- Environmental baseline documentation at both sites
Appoint a single internal relocation manager before planning begins. On larger moves, this role determines whether permit items get resolved in advance or discovered mid-move.
The upgrade window
Relocation is the right moment to evaluate upgrades. If batching controls are outdated, reinstalling old bottlenecks at the new site is a missed opportunity. If aggregate heating systems need attention, addressing them during the move avoids a second production interruption later.

Relocation projects provide an ideal opportunity to upgrade equipment, systems, and plant performance before recommissioning.
Why modular and containerized plants have a relocation advantage
Plant design is the single biggest variable in relocation cost and complexity. The Cobra and Arcamix series are built around this from the ground up: mixer units, aggregate bins, cement silos, screw conveyors, weigh hoppers, and batching controls are grouped into transportable units with standardized dimensions and plug-in utility connectors. No custom field wiring to reverse, no site-specific structural integration to undo, no bespoke foundation to abandon.
The relocation advantages show up at every stage:
- Dismantling: Disconnect utility tie-ins and lift. No structural disassembly, no component-by-component removal.
- Transport: Container-dimensioned modules load onto standard flatbed or low-loader transport without special rigging engineering.
- Site prep: Foundation-free base designs eliminate concrete civil works at the new site.
- Recommissioning: Batching controls arrive with known calibration baselines. Test batching can begin within hours of utility reconnection, not days.
- Thermal insulation: Factory-fitted insulation for cold-weather operation travels with the modules. No separate dismantling and reinstallation.
A stationary plant relocation can take 4-6 weeks of downtime. A Cobra or Arcamix relocation typically takes 1-5 days. For operators running project-based production, temporary site assignments, or multi-site operations, modular design is not a premium feature. It is the factor that makes relocation financially viable at all.
.jpg?width=1920&height=1080&name=Arcamix_concrete-mixing-plant_P304%20(1).jpg)
Modular and containerized plants are designed for efficient transport, rapid installation, and minimal site preparation.
A practical relocation checklist
Use this as a phase-by-phase reference to keep the move on track.
Phase 1: Decision and assessment
- Complete a condition audit of mixer units, aggregate bins, cement silos, screw conveyors, weigh hoppers, and batching controls
- Estimate total relocation cost including downtime, transport, rigging, civil works, utility tie-ins, and commissioning
- Compare against replacement cost with a modular or containerized plant
- Confirm the new site will operate long enough to justify the investment
- Choose the lowest-production window for the move
Phase 2: Permits and compliance
- Confirm new site permit status and any required pre-move notifications
- Verify dust suppression and particulate emissions requirements
- Secure building, utility, and transport route approvals
Phase 3: Planning
- Create a tagged equipment inventory
- Develop a rigging and lifting plan for each major module
- Define new site layout and foundation requirements
- Confirm utility tie-ins and decide which components will be reused, upgraded, or replaced
Phase 4: Site preparation
- Complete foundation or base frame installation at the new site
- Install utility connections and confirm capacity
- Verify dust suppression infrastructure is in place
Phase 5: Dismantling, transport, and installation
- Empty aggregate bins, cement silos, weigh hoppers, and screw conveyors
- Complete lockout/tagout on all electrical systems
- Execute the rigging and lifting plan and transport per approved route
- Install and reconnect at the new site
Phase 6: Commissioning and restart
- Reconnect and test batching controls and automation
- Calibrate weigh hoppers and dosing systems
- Verify moisture correction baselines
- Run test batching to confirm mix consistency before full production resumes
If the plant is modular and the move is well planned, relocation can be the fastest path to restored production. If the plant is aging, heavily fixed, or expensive to recommission, the better decision may be to upgrade or replace it with a modular or containerized solution designed for faster deployment and lower relocation cost over its full service life.
If you are weighing that decision, Tecwill can help evaluate whether your current plant should be relocated, upgraded, or replaced with a Cobra or Arcamix solution.

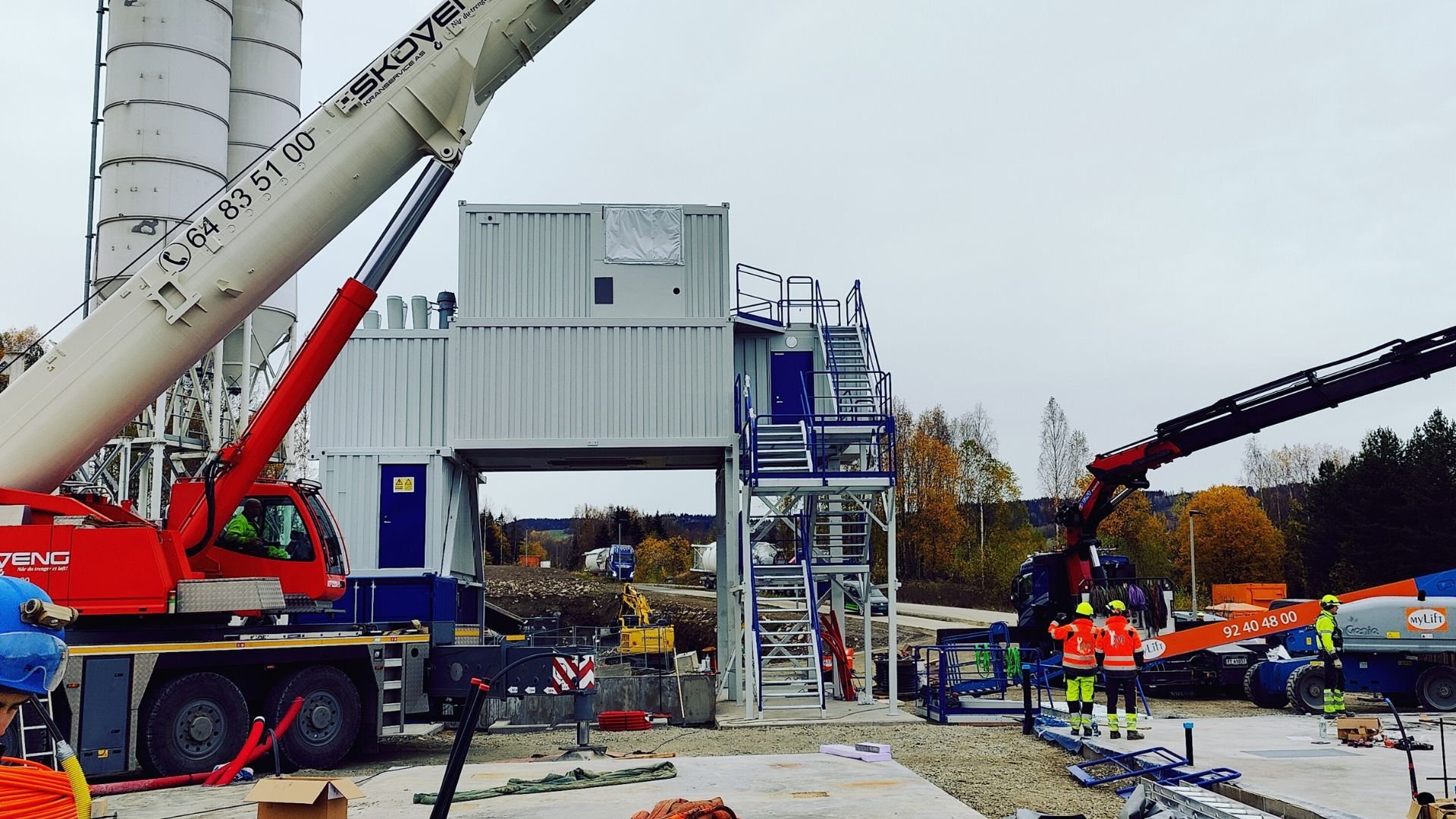

.jpg?width=1920&height=1080&name=Arcamix_concrete-mixing-plant_P304%20(2).jpg)
Modular plant installation and recommissioning can be completed rapidly when relocation is planned in advance.
Frequently Asked Questions
What is the first step in relocating a concrete batching plant?
Start with the decision, not the dismantling crew. Review downtime costs, transport, site conditions, permits, and the plant's remaining service life before committing.
How long does it take to dismantle and move a batching plant?
It depends on plant type. A Tecwill containerized plant can move between sites in 1-2 days. Stationary plants typically take weeks, with permitting, civil works, and commissioning determining the real timeline more than dismantling itself.
What permits are needed before relocating a concrete plant?
Requirements vary by jurisdiction, but most markets require site-specific environmental and operating approvals at the new location, dust suppression and particulate emissions controls confirmation, local building and utility connection permits, and transport route approvals for oversize loads. Confirm the full picture before any equipment is disconnected.
When does relocation make more sense than replacement?
Relocation makes sense when the plant is modern, in good condition, and the new site will operate for many years. If the installation is heavily fixed, outdated, or expensive to recommission, replacement with a Cobra or Arcamix solution is often the smarter investment.
Why are Tecwill's containerized plants easier to relocate?
The Cobra and Arcamix series are built in transportable modules with preinstalled equipment, factory-fitted insulation, and plug-in connectors for all utility tie-ins. Foundation-free base designs reduce civil work at both sites. The result is faster commissioning, less disruption, and a lower risk of delays.
